Missing links – Davis Street tunnelling works

What are we doing in this area?

The upgrades in the area from Waratah Mills light rail station to Johnson Park include:

  • A new tunnel under Davis Street, Dulwich Hill
  • A boardwalk from the Davis Street tunnel to Johnson Park along the light rail corridor
  • Installation of new solar smart path lights
  • Public art in tunnel
  • Wayfinding signage
  • Upgrade of drainage at Terry Road

The construction method for the new pedestrian and cycling tunnel under Davis Street is a ‘top-down’ construction method, that requires specialised equipment and includes about 85 piles. The piling is complete, the concrete has been poured for the tunnel roof, the waterproofing is installed, the asphalt has been put in place, the line marking completed, and the bridge re-opened on 17 October, approximately six months after closure. The tunnel is excavated from underneath. This is the fastest method to build the tunnel and ensured the shortest closure of Davis Street bridge.

When are we doing this?

Construction of the upgrade from Waratah Mills light rail station to Johnson Park has started in April 2024 and is anticipated to be completed in 2025.

Davis Street bridge has re-opened

Davis Street bridge in Dulwich Hill is open again, after just over 6 months of closure for tunnelling works for a new GreenWay shared path connection.

Images

Artist impression - Dulwich Hill: view towards tunnel under Davis Street, from the south looking north:

Dulwich Hill view towards tunnel from south of Davis Street

The construction method for the new pedestrian and cycling tunnel under Davis Street is a ‘top-down’ construction method, that requires specialised equipment and includes about 85 piles. The piling is complete, the concrete has been poured for the tunnel roof, the waterproofing is installed, the asphalt has been put in place, the line marking completed, and the bridge re-opened on 17 October, approximately six months after closure. The tunnel was then excavated from underneath.

Progress on the elevated shared path forming a new connection between Davis Street and Johnson Park:

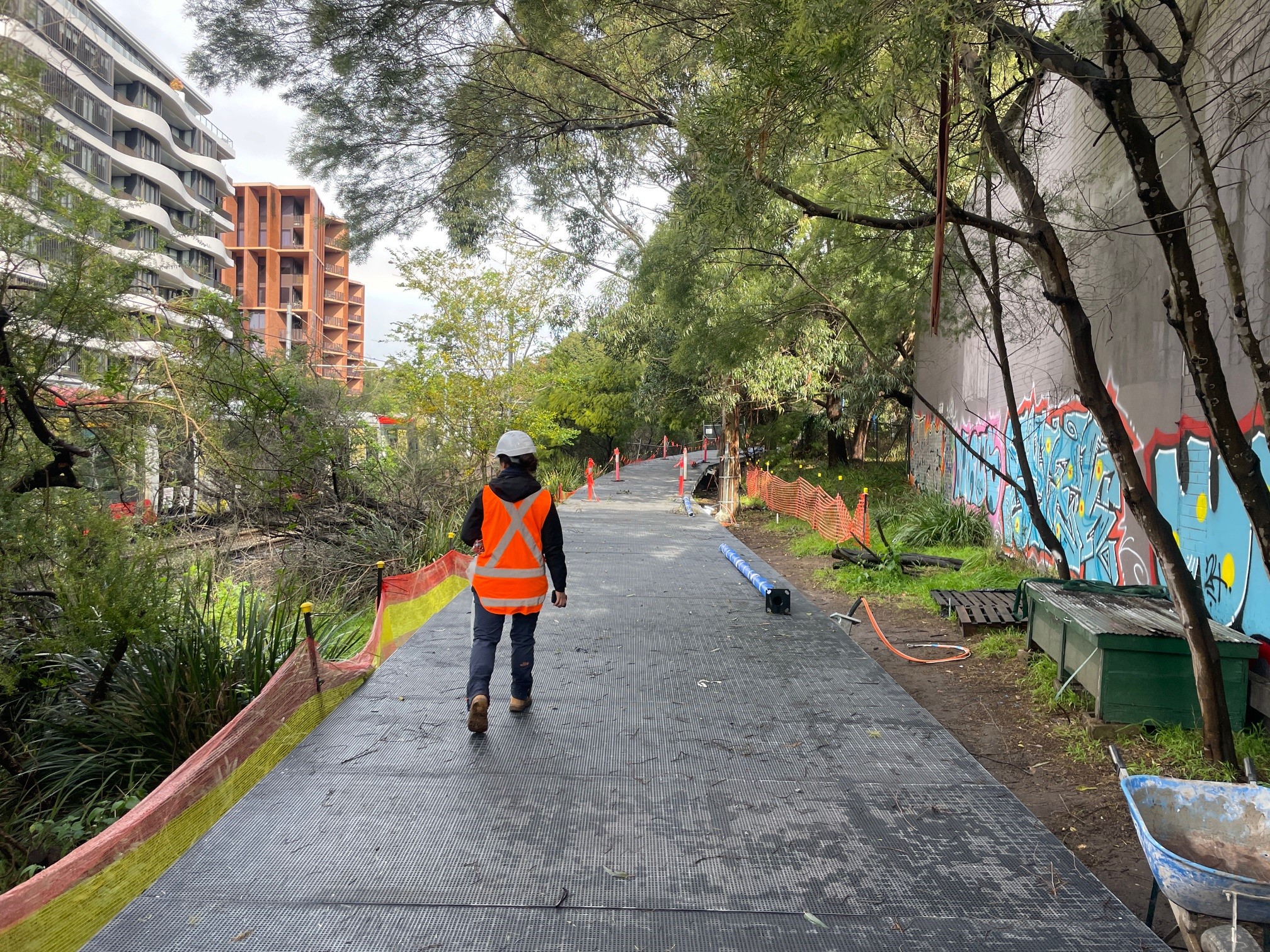

Davis St elevated path Terry Rd to JP 2 July 2025

Construction in this area includes stormwater improvement work:

Davis St stormwater works 2 July 2025

Continued tunnel works with the brick cladding now completed and the concrete for the path installed:

Davis St tunnel south looking north 8 April 2025

Davis St tunnel north looking south 8 April 2025

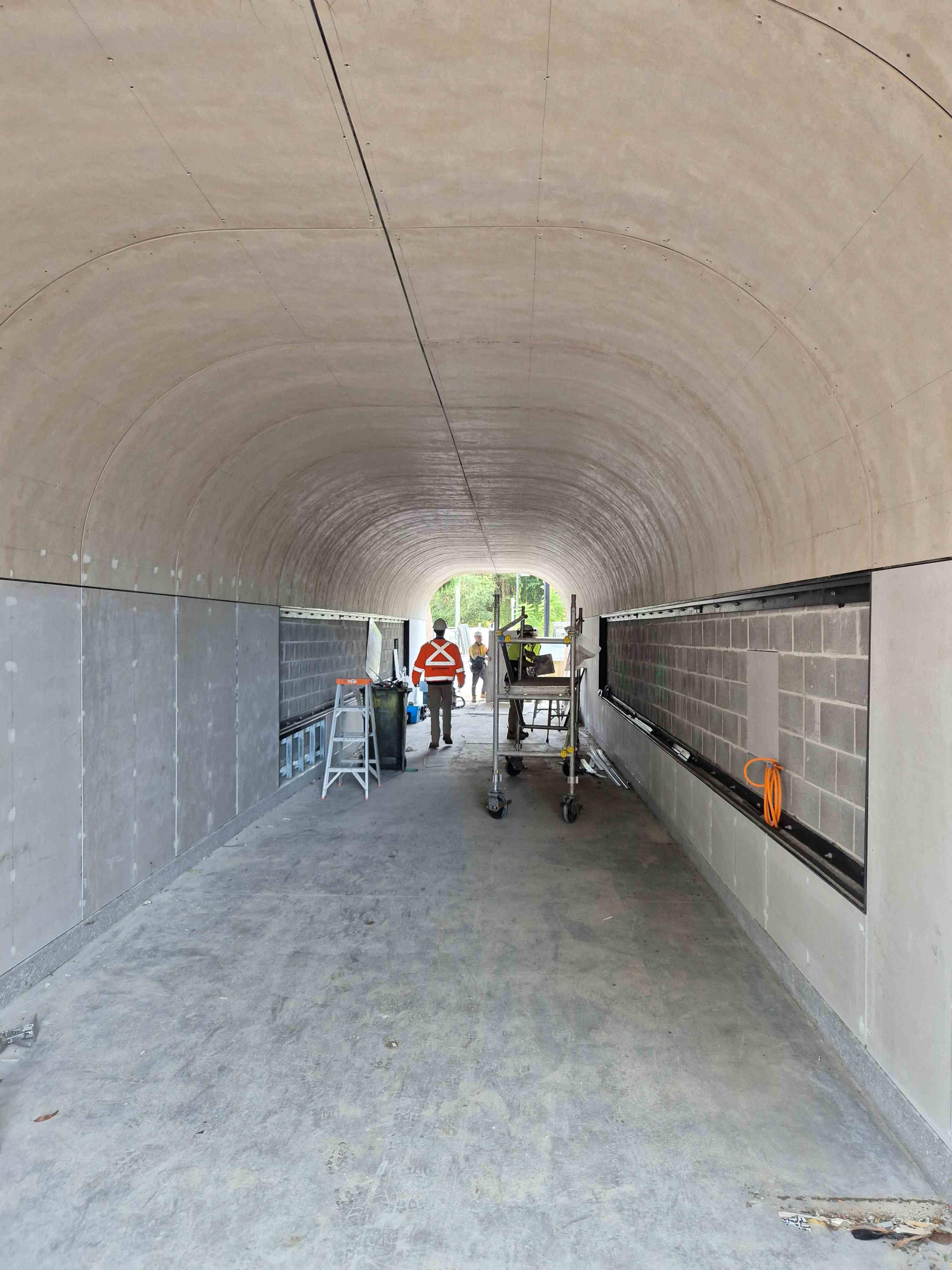

Progress inside the Davis Street tunnel:

Davis Street tunnel interior cladding 20 May 2025

First tunnel breakthrough on 20 September 2024:

Davis St tunnel breakthrough

Line markings added and Davis Street bridge reopened (17 October 2024):

Davis St bridge line marking 17 Oct 2024

explore content banner

GreenWay construction updates

Works in progress

Upcoming works

Completed works
